Treating the Substrate with Care
It is common practice in this type of dike reinforcement to first raise the dike and then install vertical drainage. Here, the order has been reversed.

Treating the Substrate with Care

The Added Value of Geotechnical Consulting

Water safety is central to the dike reinforcement project on Marken. Haskoning’s engineering team was brought on board as early as the tender phase and remains closely involved in the project even now, during the implementation phase. By conducting an in-depth analysis of the subsoil and feasibility, a smarter design was developed—one that requires less embankment and significantly smaller volumes of sand, while maintaining the same level of flood protection. It was precisely this early involvement of geotechnical expertise that proved decisive for the project’s success.

During the tender phase, Haskoning’s specialists assessed the feasibility of the reference design. “It quickly became clear that the original plans were based on using large quantities of sand,” says Clara Spoorenberg, a geotechnical specialist at Haskoning. “That would not only be costly, but also entail risks. The dike is located at the bottom of the Markermeer, where there are thick layers of soft peat. This subsoil is particularly susceptible to settlement and instability. Raising the embankment too heavily or too quickly could lead to shear failure.”

Treating the Substrate with Care 1

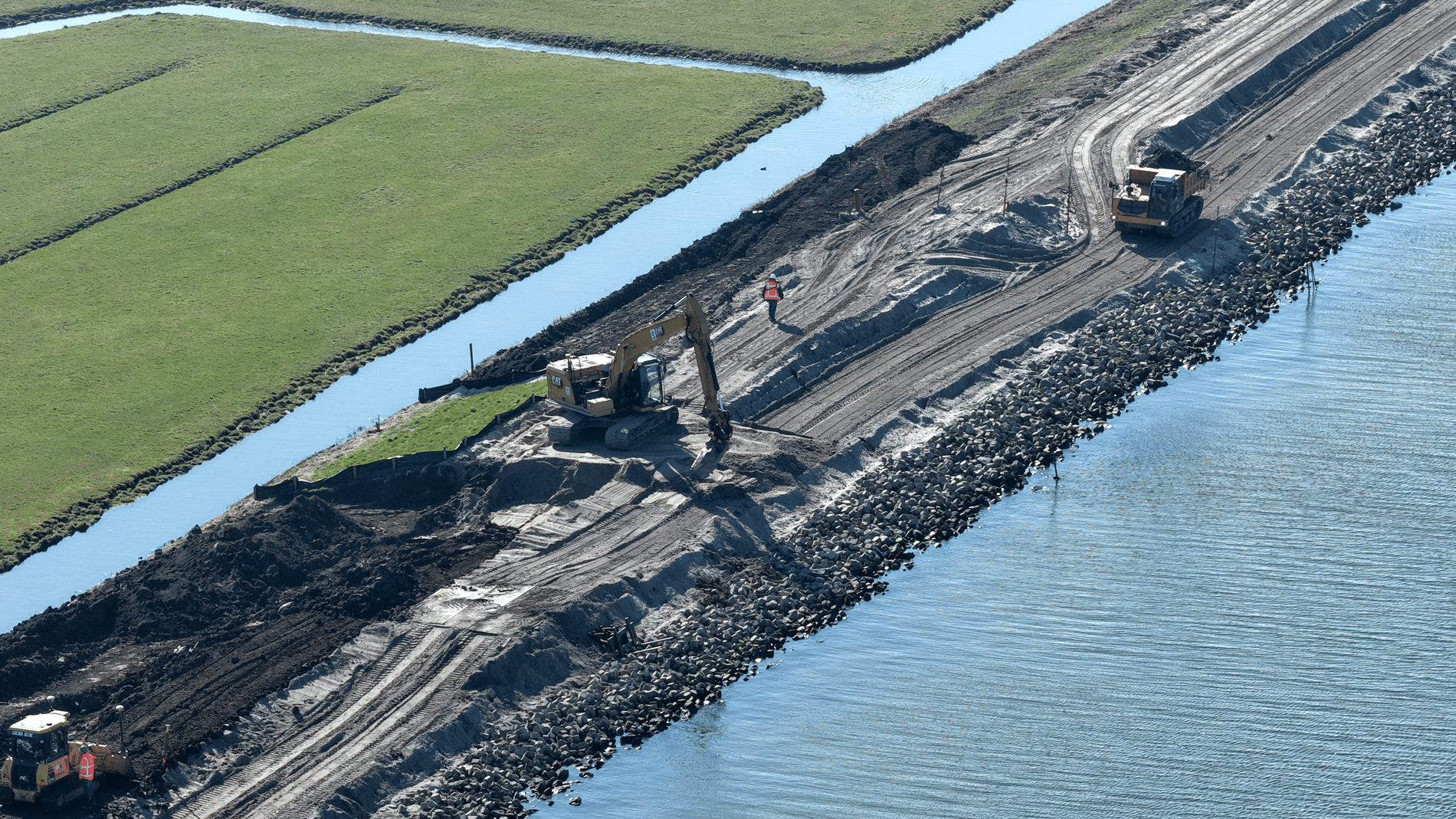

The design of the new dike will make use of the existing dike as much as possible.

Alternative design

Based on these geotechnical insights, an alternative design was developed. “Instead of a tall, relatively steep dike, we opted for a lower profile with gentler slopes,” explains Spoorenberg. “Because of that gentler slope, the wave run-up is significantly reduced, meaning the dike doesn’t need to be as high to still meet safety requirements. The result: less sand, less settlement, and a design that is simpler and safer to implement. This approach not only yielded technical advantages but also reduced the environmental impact and improved the MKI score. Ultimately, it even helped us win the tender.”

Sample sections

To test this in practice, two test sections, each 100 meters long, were constructed. “These test sections literally served as a testing ground where the contractor consortium could test various construction methods and materials,” says Jan Cirkel, project manager at Haskoning. “Think of variations in stone types, aggregates, and methods of processing and stabilization. In addition, the test sections provided valuable insights into the behavior of the subsoil. Extensive monitoring was conducted to determine how reliable the measurement data was and how well settlement behavior could be predicted. This knowledge formed the basis for the final construction strategy and phasing.”

Different Construction Sequence

The design of the new dike makes use of the existing dike as much as possible. “It’s been there for hundreds of years and has already undergone a great deal of settlement,” Spoorenberg explains. “Settlement in that area is therefore limited, and we’re taking full advantage of that. A second important difference lies in the construction sequence. Typically, with this type of dike reinforcement, the dike is raised first, and then vertical drainage is installed. Here, the order was reversed. First, a thin layer of sand was applied, into which vertical drains were installed. Only then were another eight layers of fill, each 50 centimeters thick, added in phases. This approach allowed for better control of the subsoil and made it possible to build faster and with greater certainty.‘

Treating the Substrate with Care 2

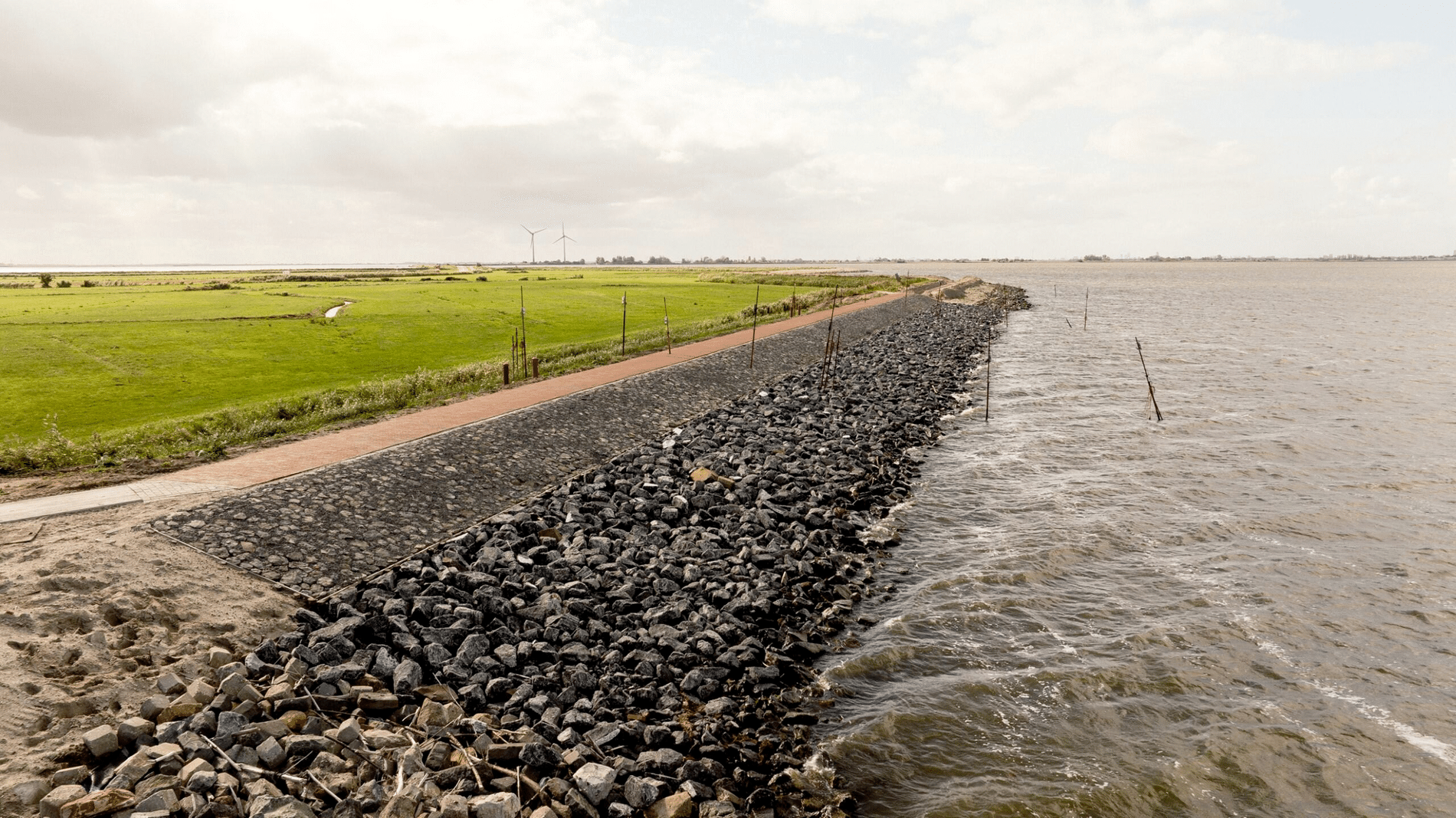

The most critical phase (the raising of the foundation) has now been completed, and a solid foundation for the future is in place.

Water safety

Safety is a constant priority during construction. “The contract stipulates that water safety must not be compromised at any time compared to the original situation,” says Cirkel. “This places high demands on the preparation and justification of every construction step, as laid out in a Water Safety Plan. For every action—such as removing existing revetment or applying layers of sand—it must be demonstrated that stability remains guaranteed. It’s an intensive process of monitoring, analysis, and coordination between design and construction teams.”

The most critical phase—the embankment work—has now been completed, and a robust foundation for the future is in place. According to both engineers, the strength of this project lies unequivocally in the early incorporation of geotechnical advice and the application of that expertise all the way through to the supervision of the construction phase. ‘By making clear-cut decisions as early as the tender phase, we arrived at a design that is not only safer and more sustainable but also easier to implement. With less sand, less risk, and more control—exactly what’s needed when building on sensitive ground.“
